Compressed Turnaround Windows
TAR scope competes for cranes, permits, and laydown space inside a fixed shutdown window. A package that stalls in the field consumes shutdown hours.

Refineries, SAGD facilities, and chemical plants execute capital work inside operating units, where permits, isolations, and access windows constrain every crew. AWPBI brings constraint-tracked work packaging in openAWP, our AWP software, and 3D-linked reporting to oil and gas projects and turnarounds, alongside the workface planning, AWP, and information management our team delivers on the same projects.
TAR scope competes for cranes, permits, and laydown space inside a fixed shutdown window. A package that stalls in the field consumes shutdown hours.
Work inside an operating unit needs permits to work, isolations, and controlled access. A missed constraint stops a crew at the gate.
When EWPs slip or revisions land mid-build, the CWPs and IWPs built on them go stale, and the path of construction drifts from what the field actually receives.
Weekly spreadsheet rollups cannot keep pace with a TAR measured in shifts. A slip that shows up in a weekly rollup is already several shifts old.
Why openAWP Fits Oil and Gas
Plan Installation Work Packages Before Mobilization
Break scope into constraint-free installation work packages along the path of construction. Each IWP holds its discipline, CWP, crew, and the 3D components it covers.
Release Only What's Ready
Packages sit on a lookahead Gantt, and one with an open constraint (drawings, materials, scaffolding, or tools) can't be released to the field.
See Current Field Status

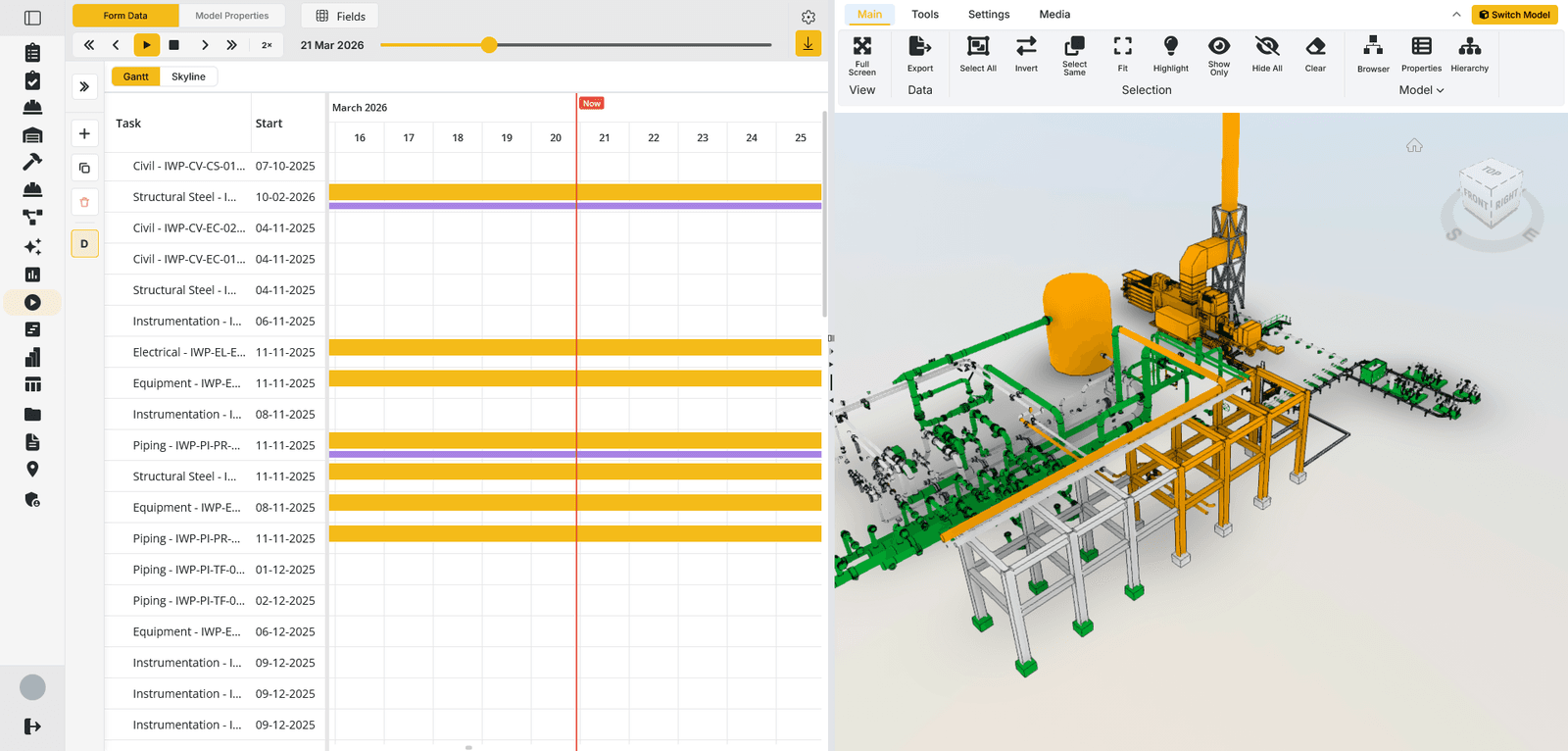

Field teams record progress on each tag by milestone. It rolls up to IWPs and CWPs, and 3D status reports and Power BI read the same numbers.
You Own the Platform
openAWP has no license fee and runs on your infrastructure or ours. It molds to your data requirements (there is no hardcoded package structure), and on your infrastructure the software and data stay with you after the engagement.

Book a live demo of openAWP, or talk to our team about constraint-tracked work packages for your next turnaround.
